An M.G. Locost Build
views: 3,160

November 15, 2011
The Plan

With nothing better to do at work, we set up our Locost build in Microsoft Project. I think we included every step, in a total of 18 major tasks. We used actual time for things we’ve already done, and estimated times for everything else. Assuming no more do-overs, which of course is crazy talk, the whole build should take just over 2100 hours. We’ve got just over 250 hours in it now, which means we're 12% done. However if the project grows to 3000 hours, which is practically inevitable, we're only 8% done. Actually, even that sounds pretty good.

Although we know things will take longer than expected, we can’t just add hours to the project plan indiscriminately by padding each task, because we can’t predict where the screw-ups will occur, only that they will occur. Kind of like quantum physics that way. If a task takes longer than expected, we’ll update the plan at that time, and that way we’ll have a complete record of how much time each step took. Measurement determines reality.

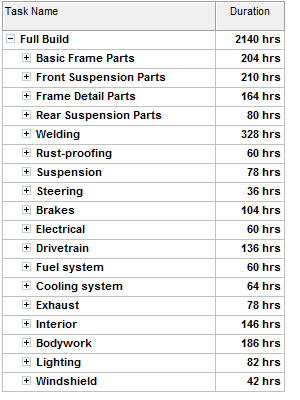

The Locost Build according to Microsoft
Project

Microsoft Project lets you specify working times for each day of the week, and for any specific day, like Christmas or Superbowl Sunday, when we're unlikely to be working at all. We have it set for 24 hours a week, mostly Saturday and Sunday. As it happens we’ve averaged only about 20 hours a week so far, due to work, vacations, club events, race dates, parties, and other obligations. That will likely continue, but since we don’t know our schedule that far in advance, we can only take days away from the project as we learn about them.

With all of those caveats, we can still look at the schedule and see what we expect to be working on for the next year or so, at least in a perfect world, and also how much time things have taken so far. Of eighteen major tasks in the build, the longest is welding at 328 hours. For some reason the shortest turned out to be the steering setup, at only 36 hours, so maybe that's not a major task.

It’s interesting to note that the upper control arms took 94 hours, and the lower control arms—which are only 66% complete and could therefore take longer—are projected out at 116 hours. That 210 hour total is almost 10% of the entire build. No wonder they seemed to take forever. By the time the frame is built, we’ll be just under a thousand hours into the project. The Locost book says you’re about half done at this point, and up until now we really didn’t believe it. But a thousand hours. Turns out that’s actually pretty accurate.

Microsoft Project doesn’t only track your hours, it also calculates dates. According to the plan, welding will commence on Friday, February 24th, and wrap up on Friday May 11th. We start the engine transplant—and therefore need a donor—on July 28th. We’ll be working on the brakes in June, and the cooling system in September. Of course the most significant date of all is that magical day when all the work is done, and our Locost is presented to the DMV for certification and registration. That date is February 11th of 2014. Likely? Hardly, but you never know. We could get lucky and absolutely nothing else will go wrong for the rest of the build.

About

Our Locost
Our Build Plan
Building a Locost
Build Summary
Workshop Manual
Construction Manual
Non-Locost Stuff

Our Build Log

Search log entries

Home       Previous Entry       Next Entry       Latest Entry
Comments:
posted February 29, 2012 at 19:36:39
Nick here. I have to add a note that the schedule changed somewhat since we wrote this back in November of 2011. And we're probably not done changing it. For the latest update, click the Our Build Plan link at the top of the page.
posted February 21, 2014 at 10:38:37
Nick again. The build is now officially done, and although the hours per task ended up different from this original plan, and some tasks even changed towards the end of the project, the total actual build hours came in at 2228. So while we were not quite on time or even on budget, we were close.

Far more remarkable than the actual build hours was the completion date. Two years before it happened, we said we would be getting our license plates from the DMV on February 11, 2014. We actually got them on February 13, 2014. Quite a coincidence.
